Awaab's Law does not primarily ask social landlords to repair faster. It asks them to prove, on a date someone else chooses, exactly when they were told about a hazard, what they did, and when. That is a records problem wearing a repairs problem's clothes, and Phase 2 widens it considerably from 30 November 2026.
The law is named after Awaab Ishak, who died in 2020 at the age of two from a respiratory condition caused by prolonged exposure to mould in his home. The duties it creates are specific, they carry fixed clocks, and the evidence that they were met has to exist somewhere a regulator can see it.
Awaab's Law is being introduced in phases, with a test and learn period between each one.

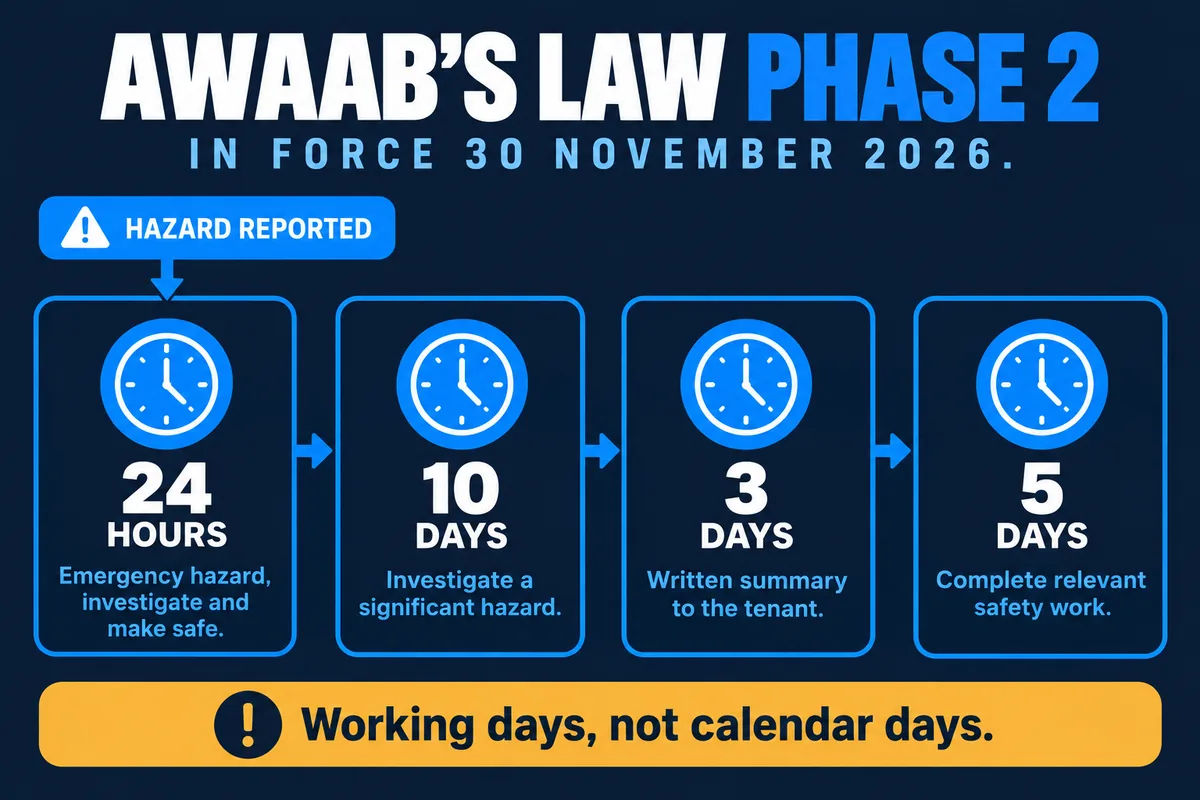

| Phase | In force | Hazards covered |
|---|---|---|
| Phase 1 | 27 October 2025 | All emergency hazards, and significant damp and mould |
| Phase 2 | 30 November 2026 | Adds excess cold, excess heat, falls on the level, structural collapse, fire and explosions, electrical hazards, domestic hygiene |
| Phase 3 | To be confirmed | The remaining HHSRS hazards, excluding overcrowding |
The duties themselves do not change in Phase 2. The range of things that trigger them does, and it roughly doubles. A landlord that has built its process around damp and mould reports now has to apply the same clocks to a cold flat, a loose handrail, a faulty consumer unit and a blocked waste pipe.
These come from the government guidance on timeframes for repairs.
| Step | Significant hazard | Emergency hazard |
|---|---|---|
| Investigate | Within 10 working days of being made aware | Within 24 hours |
| Written summary to tenant | Within 3 working days of the investigation concluding | Within 3 working days |
| Relevant safety work | Within 5 working days of the investigation ending | Within 24 hours |
| Supplementary preventative work | As soon as reasonably practicable, 12 week backstop | As soon as reasonably practicable |
This is worth pausing on. A considerable amount of published material, including guidance pages on council websites, still quotes 14 calendar days to investigate and 48 hours for the written summary. Those are the figures from the consultation stage. The regulations landed on 10 working days and 3 working days.
Over an ordinary fortnight the two counts are close enough that nobody notices. Over Christmas, Easter or a run of bank holidays they separate by several days, and a team working to a calendar day count will believe it is compliant while the statutory clock says otherwise. Any system that calculates these dates needs a working day calendar behind it, not an arithmetic one.
This is the question that decides most disputes, and it is more generous to the tenant than people expect. A landlord is made aware of a potential hazard when it is told by the tenant, when it is notified by a third party, or when the issue is discovered during a routine inspection or visit.
So the clock can start without anyone making a complaint at all. A gas engineer attending an annual service who notes black mould in a bedroom has started it. A neighbourhood officer who sees a cracked panel on a walkway has started it. A social worker who phones the housing team has started it.
In most organisations those three routes land in three completely different places: a job note in the contractor's system, a line in a visit report, a voicemail. If the only durable record of a hazard being reported is in a contractor's own system or an officer's notebook, the organisation cannot evidence when it was made aware, which means it cannot evidence that it met the deadline even when it did.
The guidance expects landlords to keep accurate and up to date information about residents and their homes, together with clear records of all engagement, investigations and communications with tenants. For enforcement, the test is whether the landlord can show it took all reasonable steps to comply.
That phrase does most of the work. It means the defensible file is not just the repair record. It is:
None of that is exotic. What makes it hard is that those six things are usually produced by five different systems and three different organisations, and the only place they come together is in somebody's email.
Most social landlords are not failing to do repairs. They are failing to be able to show, quickly and in one place, the sequence of events for a specific property on a specific date eighteen months ago.
The housing management system holds the case. The contractor's system holds the job. The surveyor's photographs are on a phone or in a cloud folder. The written summary to the tenant is in Outlook. The access attempt that failed is a line in a log that may or may not still exist. When the Housing Ombudsman or the Regulator of Social Housing asks what happened, assembling that story is a research project, and the gaps in it are indistinguishable from non-compliance.
The same shape of problem turns up wherever a statutory clock meets a paper trail. We have written about it in the context of NHS records retention and BRCGS Issue 10 food safety records, and the lesson repeats: the organisation is usually compliant and usually cannot prove it.
DocFlow is a document management platform rather than a housing management system, and it is not a replacement for one. What it does is hold the evidence layer underneath: capture from any source, filing against the property and the case, retention applied automatically, and an audit trail of every access, amendment and disposal that cannot be altered after the fact. Where the question is what can you prove and when did you know, that layer is the answer.
DocFlow is built and supported in the UK by Mastercopy, and has been serving organisations in regulated environments since 1989. If your answer to "when were we first told about this" currently involves searching three systems and an inbox, that is the gap worth closing before November.
Sources: the phase dates and hazard categories follow the government's Awaab's Law collection and the Phase 2 guidance for social housing landlords. The statutory timescales, the definition of being made aware and the reasonable steps test are taken from the guidance on timeframes for repairs in the social rented sector. Last reviewed 2 October 2026.
For a significant hazard, the landlord must investigate within 10 working days of being made aware, provide the tenant with a written summary of the findings within 3 working days of the investigation concluding, and complete relevant safety work within 5 working days of the investigation ending. For an emergency hazard, investigation and safety work must both happen within 24 hours. Where supplementary preventative work cannot begin within 5 working days, it must start as soon as reasonably practicable, with a 12 week backstop.
Working days. A number of published summaries still quote figures from the consultation stage, including 14 calendar days to investigate and 48 hours for the written summary. The regulations and the current government guidance use working days: 10 to investigate, 3 for the written summary, 5 for the safety work. The distinction matters around bank holidays and the Christmas period, when a working day count and a calendar day count drift several days apart.
Phase 2 comes into force on 30 November 2026. Phase 1, in force since 27 October 2025, covered emergency hazards and significant damp and mould. Phase 2 extends the same duties to excess cold, excess heat, falls on the level, structural collapse, fire and explosions, electrical hazards and domestic hygiene. A later phase will extend to the remaining Housing Health and Safety Rating System hazards, excluding overcrowding.
More than a formal complaint. The clock starts when the landlord is notified by the tenant, notified by a third party, or finds the issue during a routine inspection or visit. That is the part most often under-recorded, because a surveyor noticing something on an unrelated visit starts the same statutory clock as a written complaint, and if that observation only exists in an engineer notebook there is nothing to evidence when it began.
The guidance expects landlords to hold accurate and up to date information about residents and their homes, and clear records of all engagement, investigations and communications with tenants. For enforcement purposes a landlord must be able to show it took all reasonable steps to comply, which in practice means documenting attempts to gain access and communications with contractors as well as the investigation itself. The duty is evidential, so a repair that happened but cannot be evidenced is treated much like one that did not.
The regulations allow for it, but only on the record. Where supplementary preventative work cannot begin within the 5 working day window, the landlord must take steps to begin as soon as reasonably practicable, subject to a 12 week backstop for physical commencement. The defence rests on being able to demonstrate reasonable steps, including failed access attempts and contractor availability, which is a documentation exercise rather than a repairs one.
The duties described here apply to social landlords in England, meaning councils and housing associations. The government has stated an intention to extend equivalent requirements to the private rented sector through the Renters Rights Act, but the phased regulations in force now are the social rented sector ones. Private landlords planning ahead would be sensible to build the same evidence trail.
By making the timeline provable rather than reconstructible. Every report, photograph, survey, written summary, contractor instruction and access attempt lands against the property and the case with a date stamp nobody can edit afterwards. The question an inspector asks is not whether you fixed it, it is when you were told and what you did next, and that question is answered by a record or it is not answered at all.
